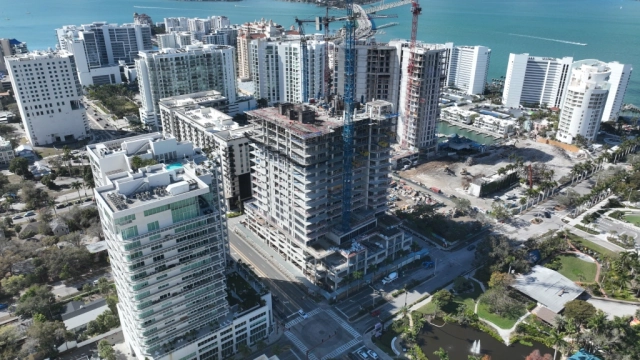

February 2026

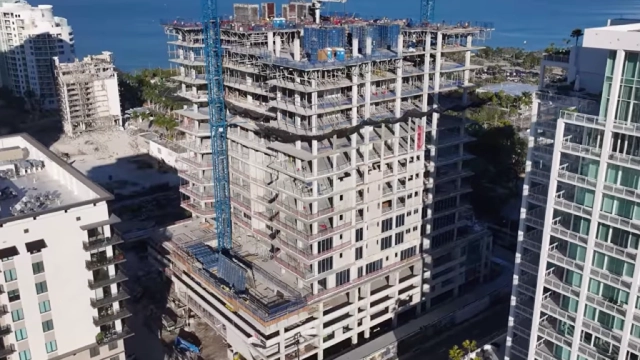

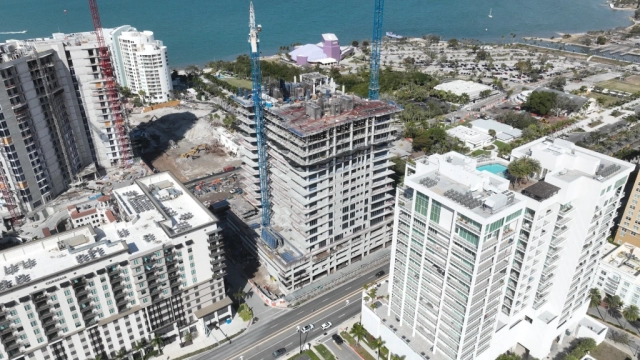

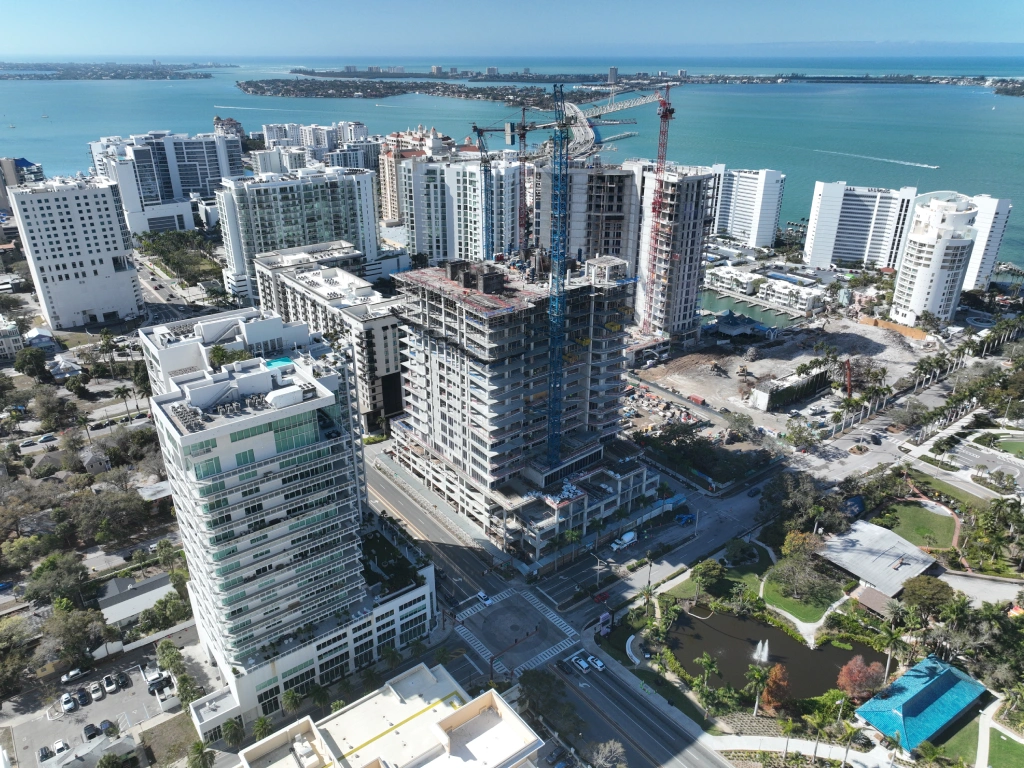

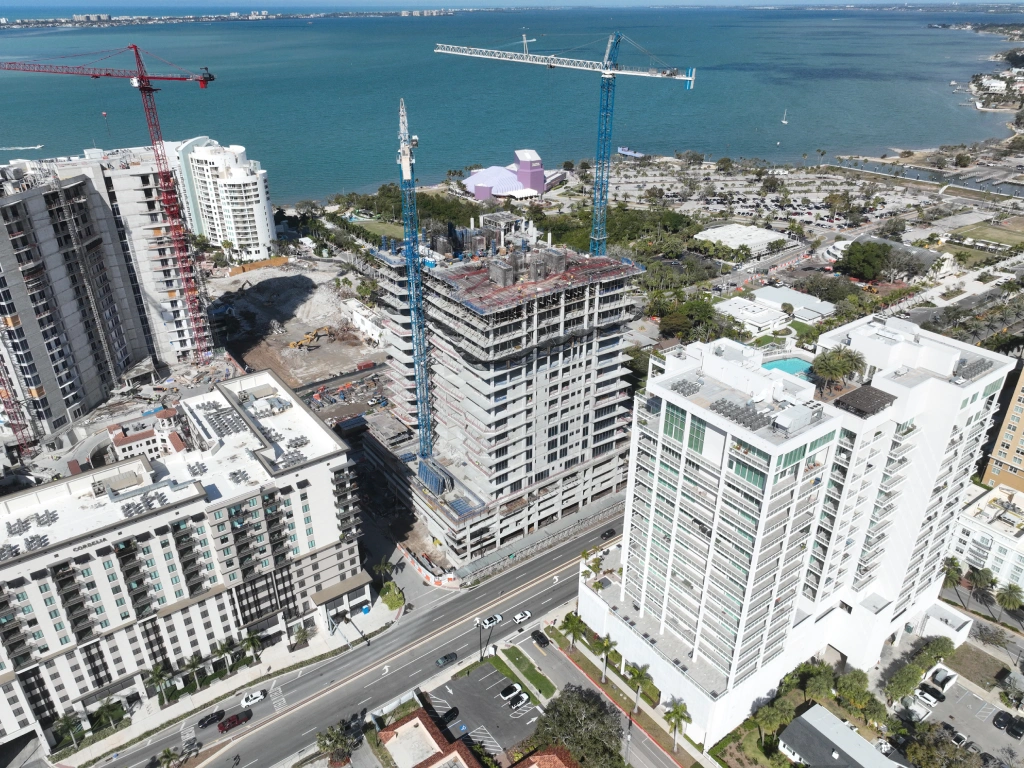

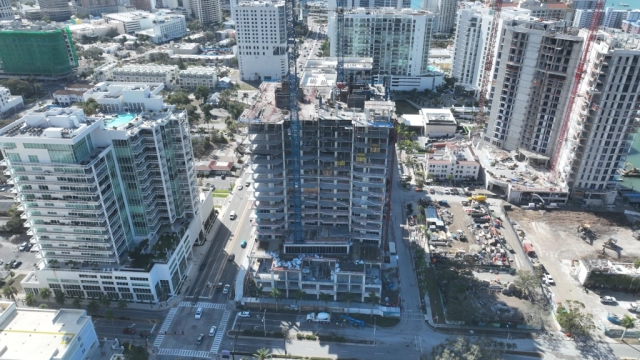

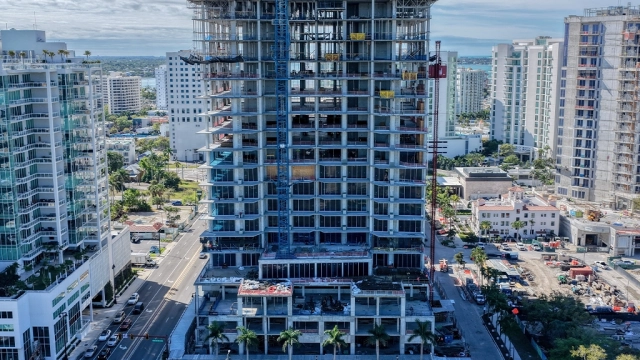

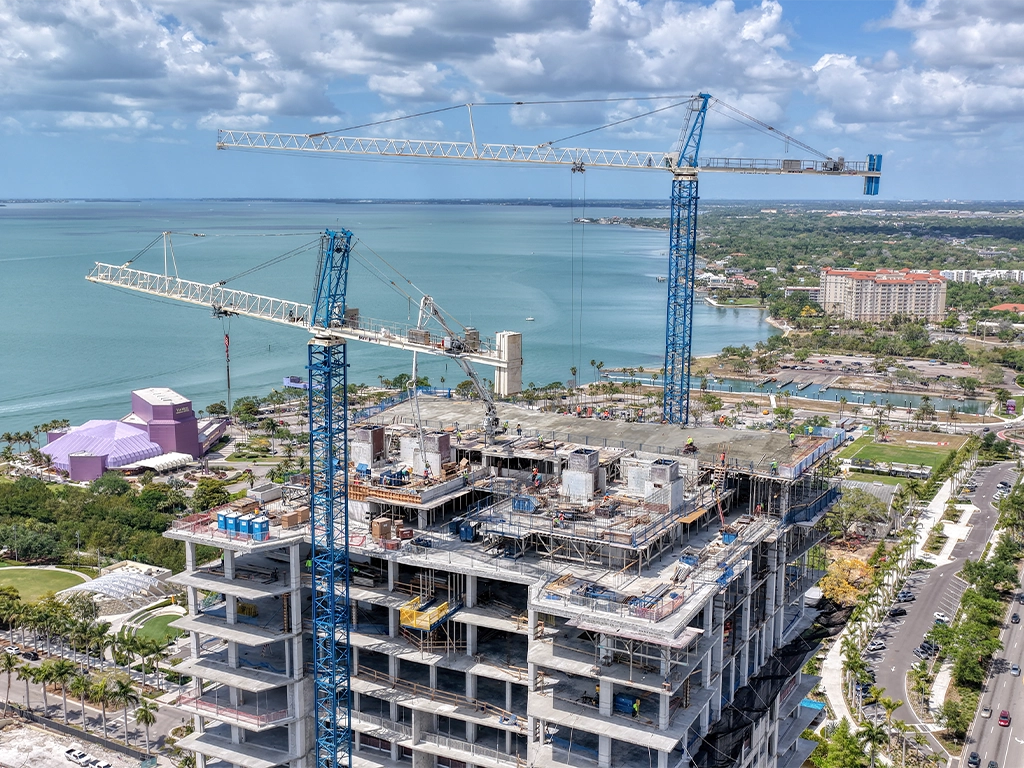

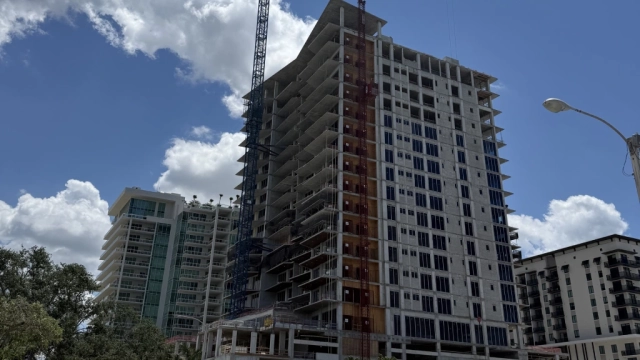

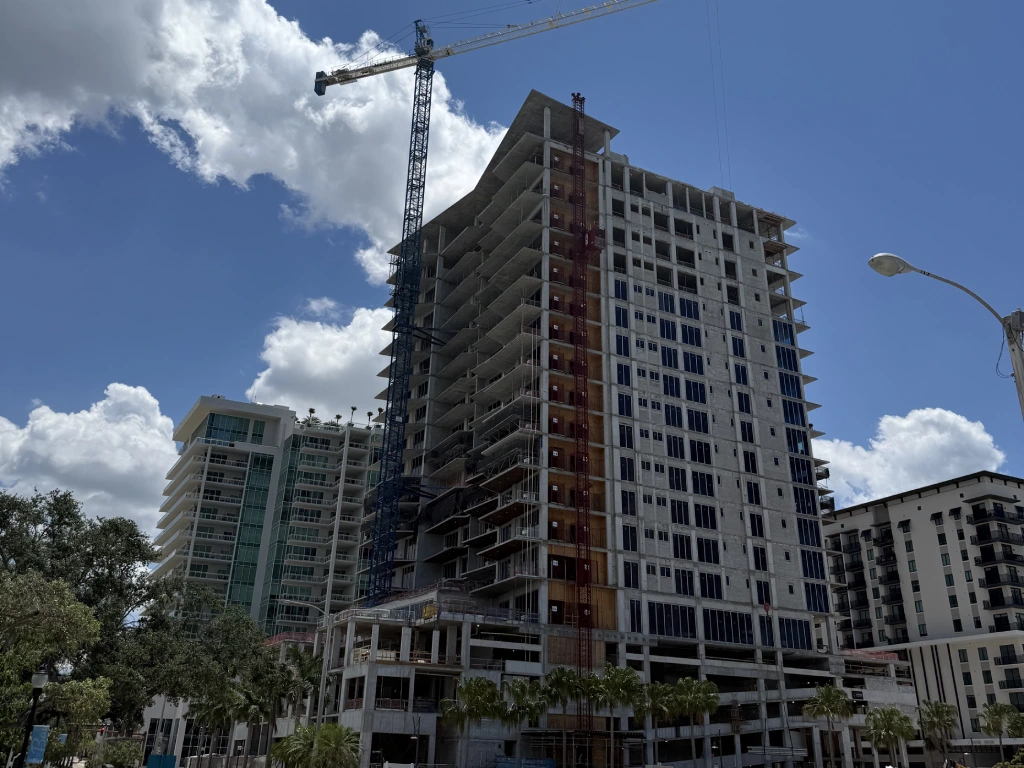

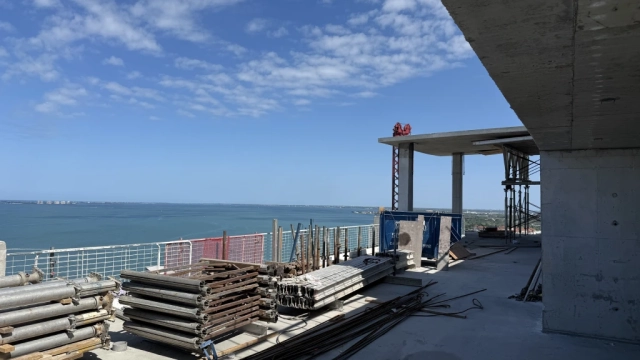

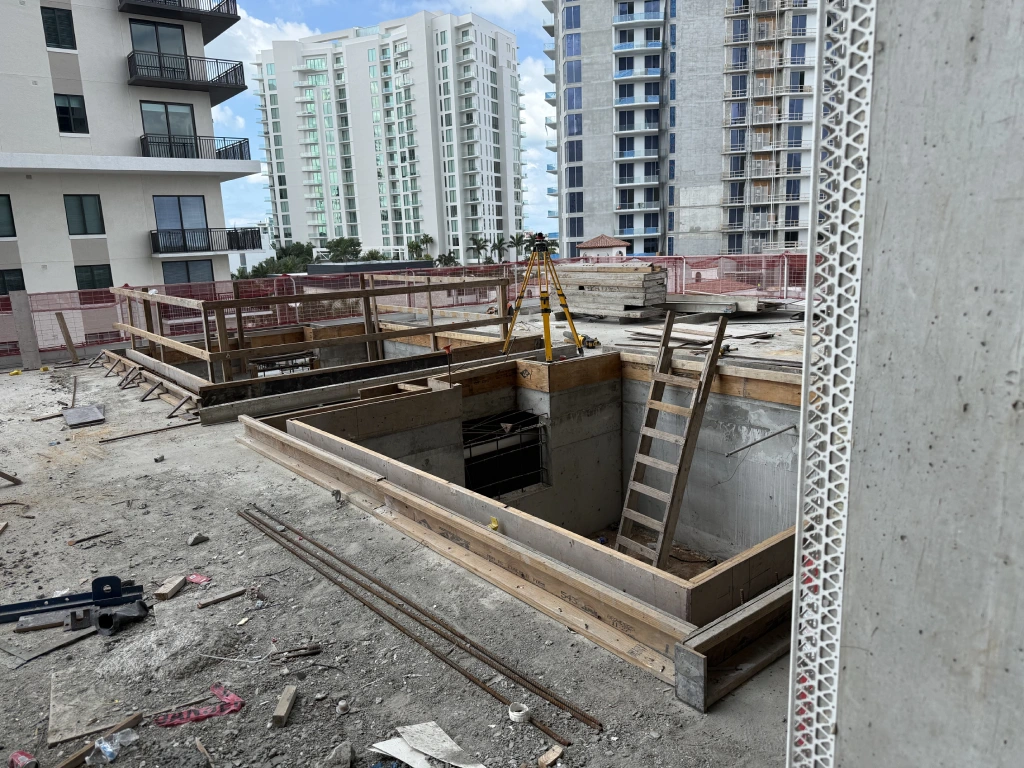

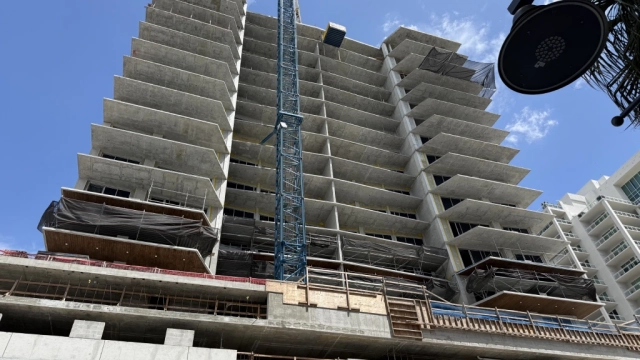

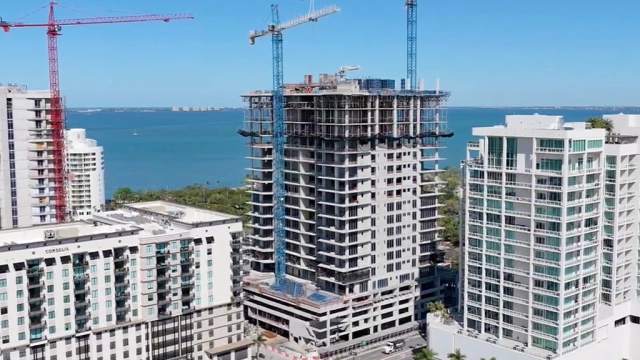

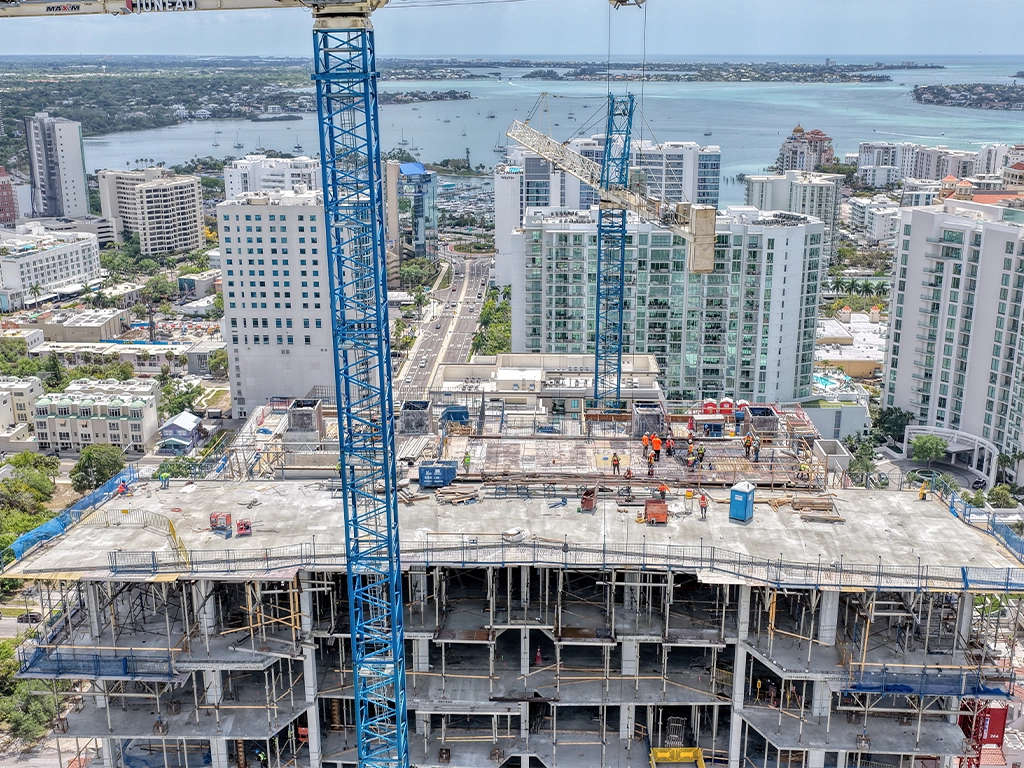

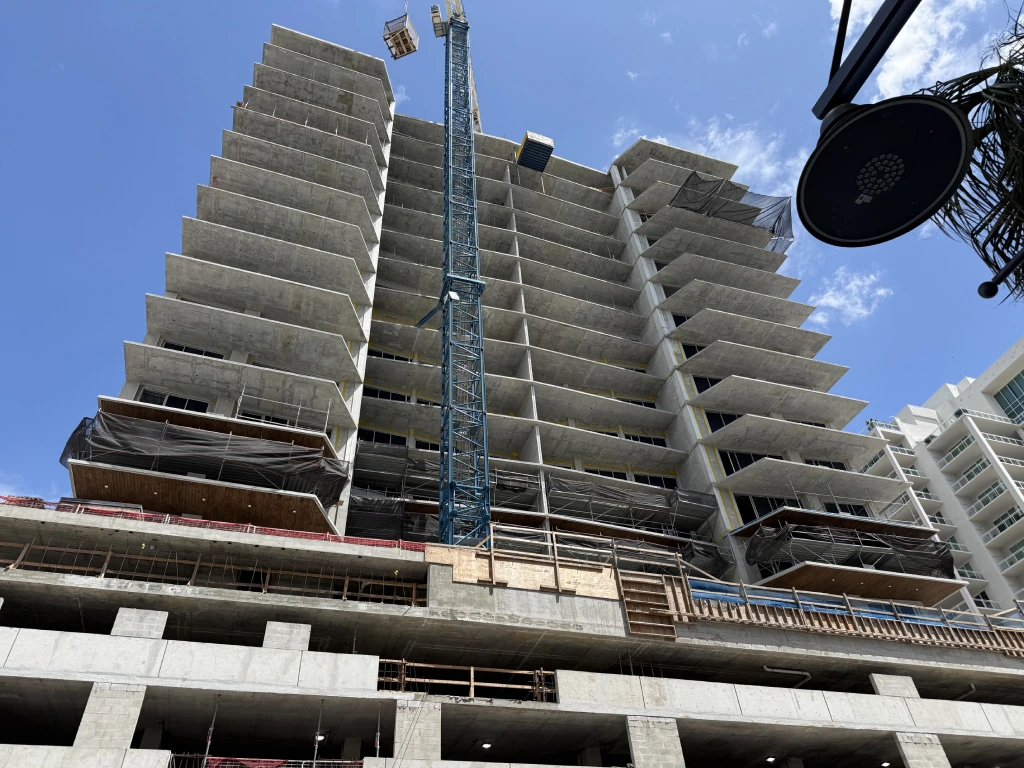

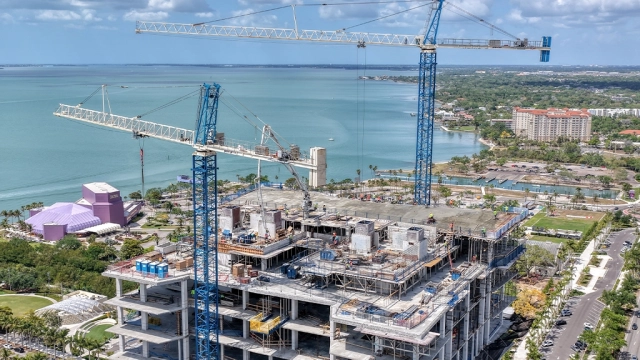

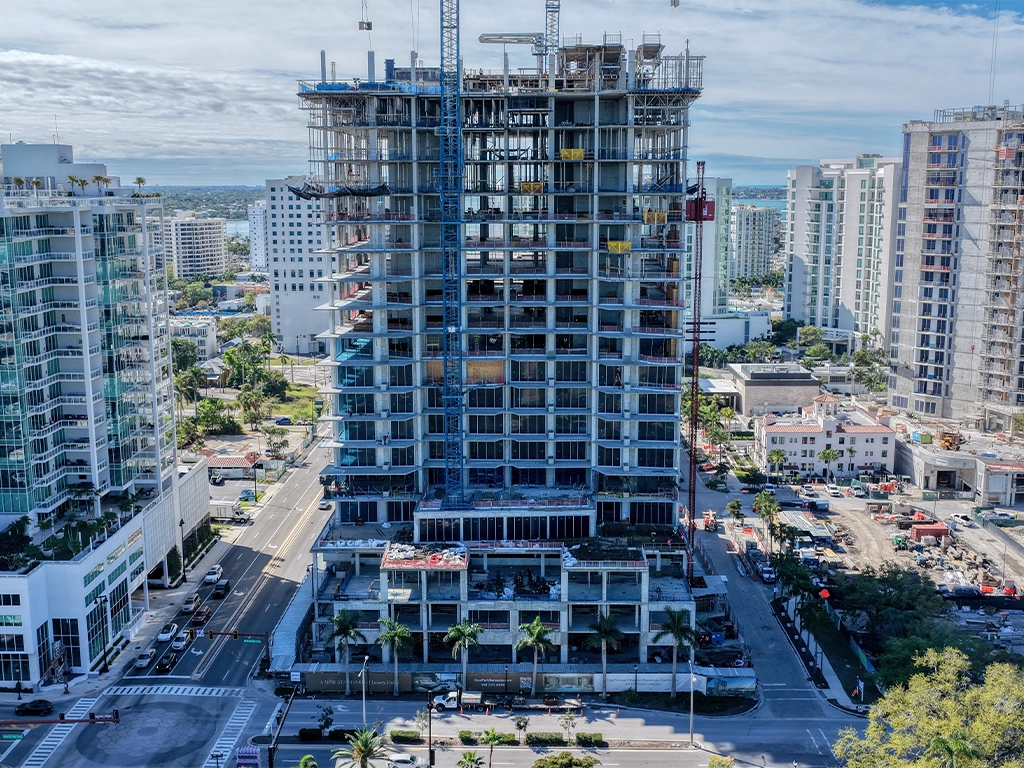

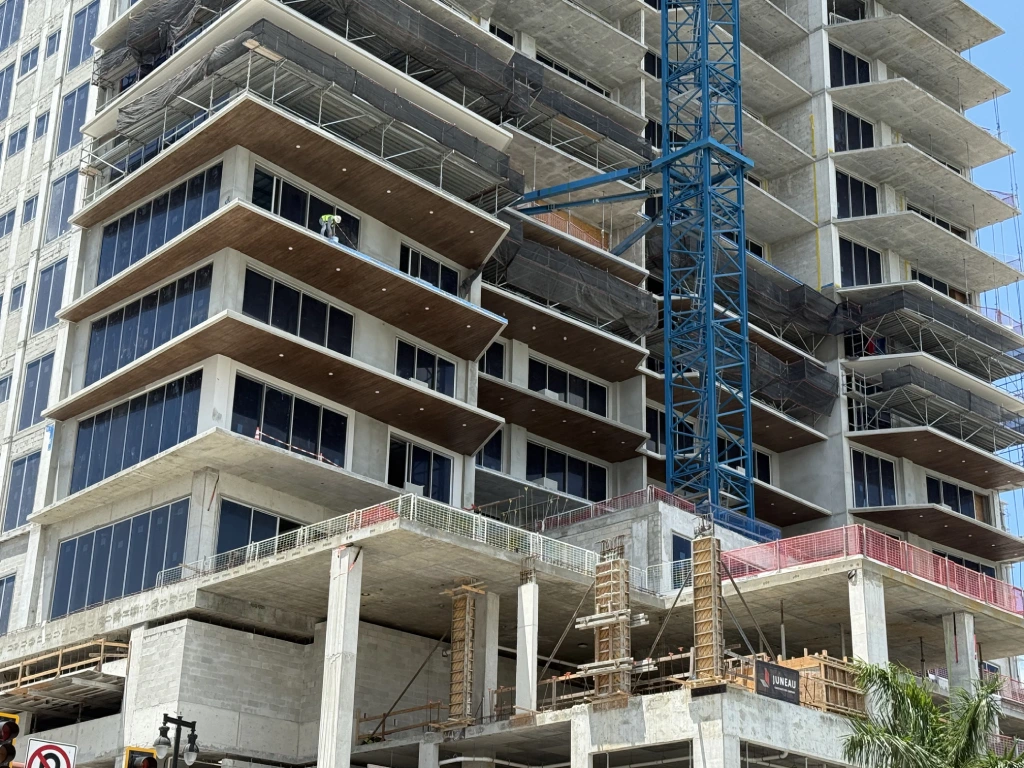

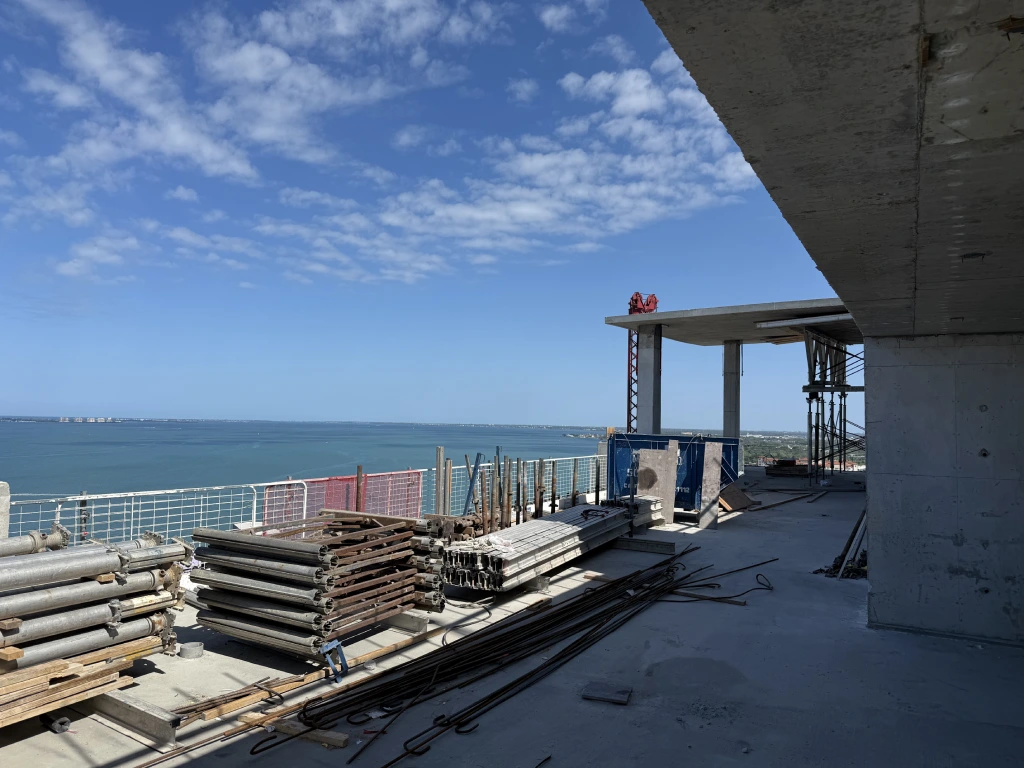

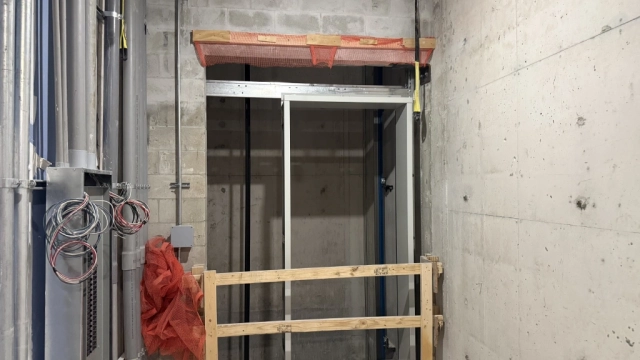

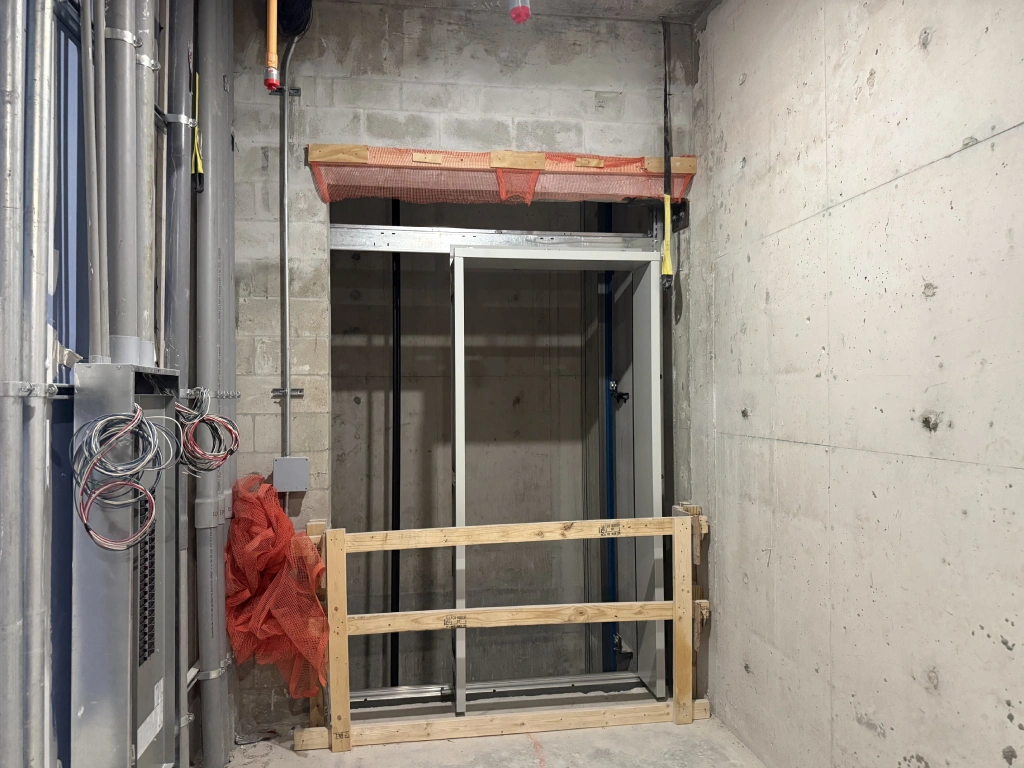

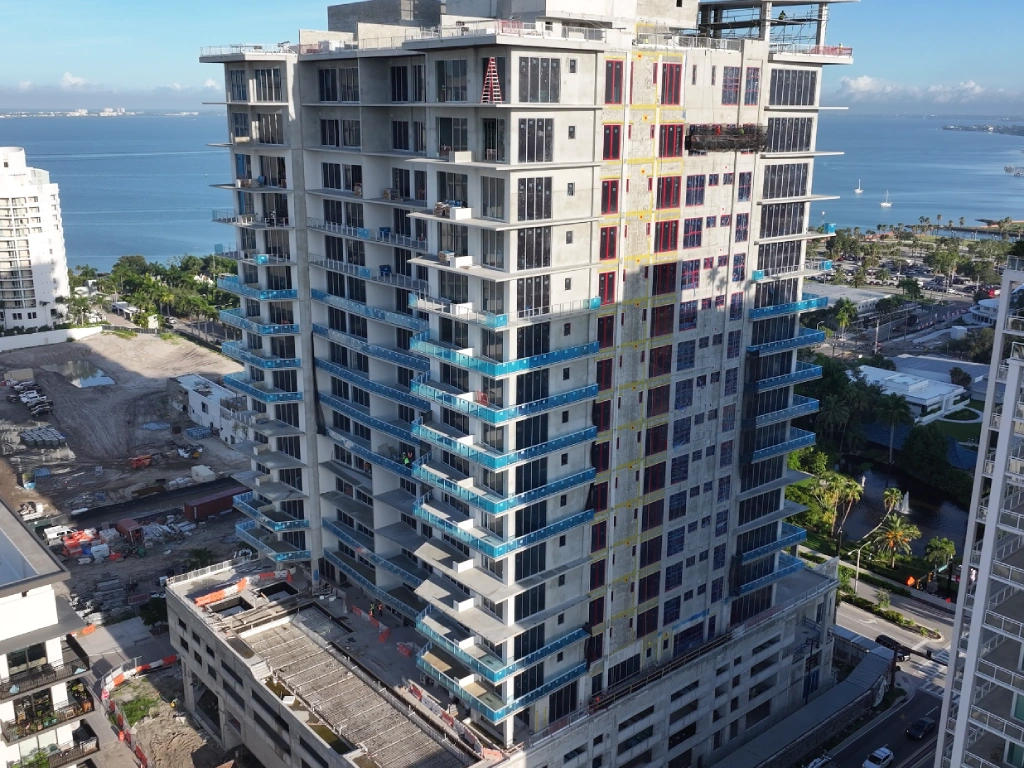

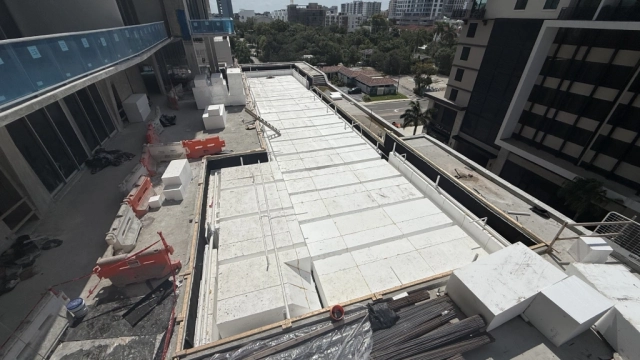

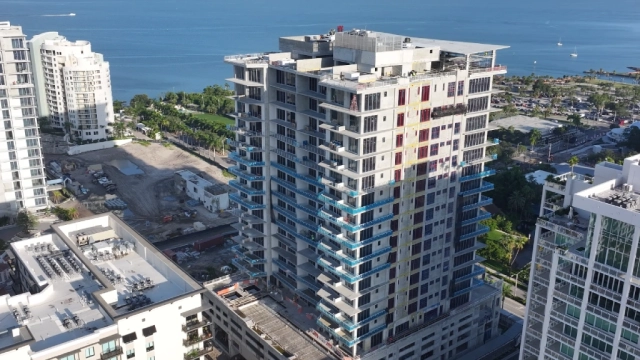

- Currently on Level 19: Structural work has advanced to Level 19, with crews actively progressing upward and maintaining schedule milestones.

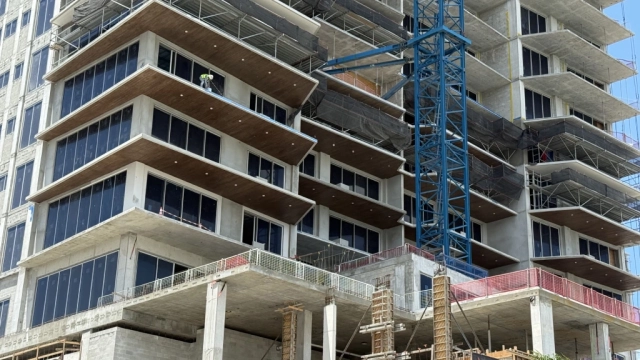

- Windows continue through Level 8: Window installation is ongoing through Level 8, providing enclosure and weather protection on lower floors.

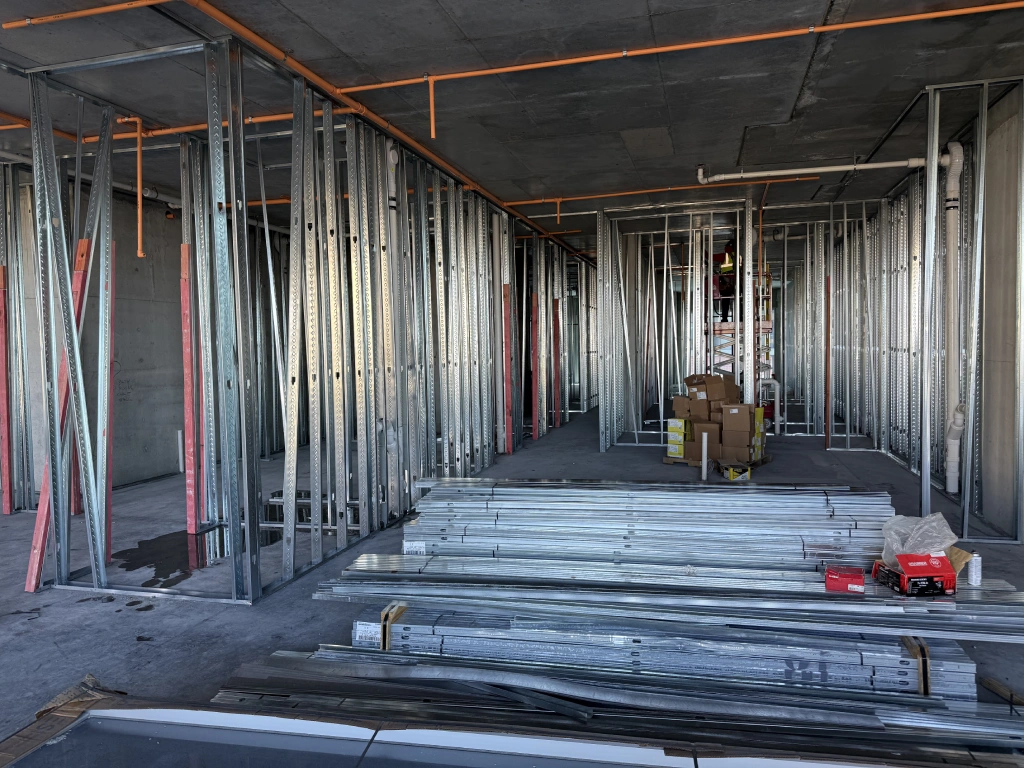

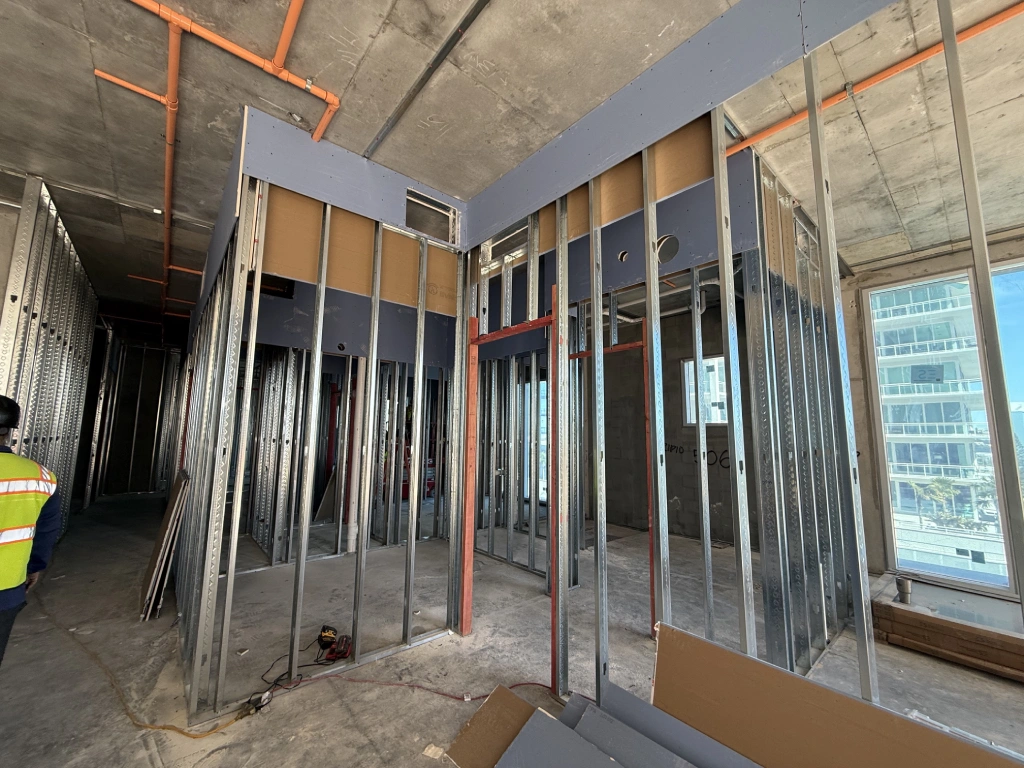

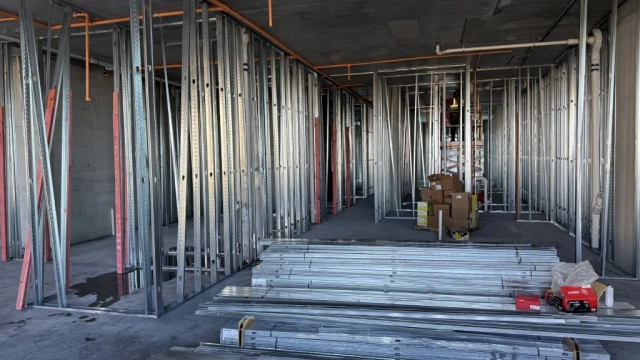

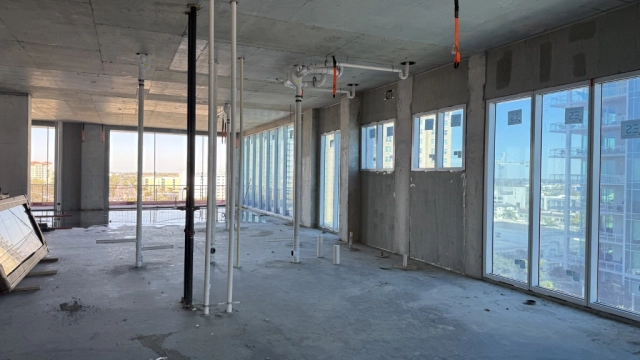

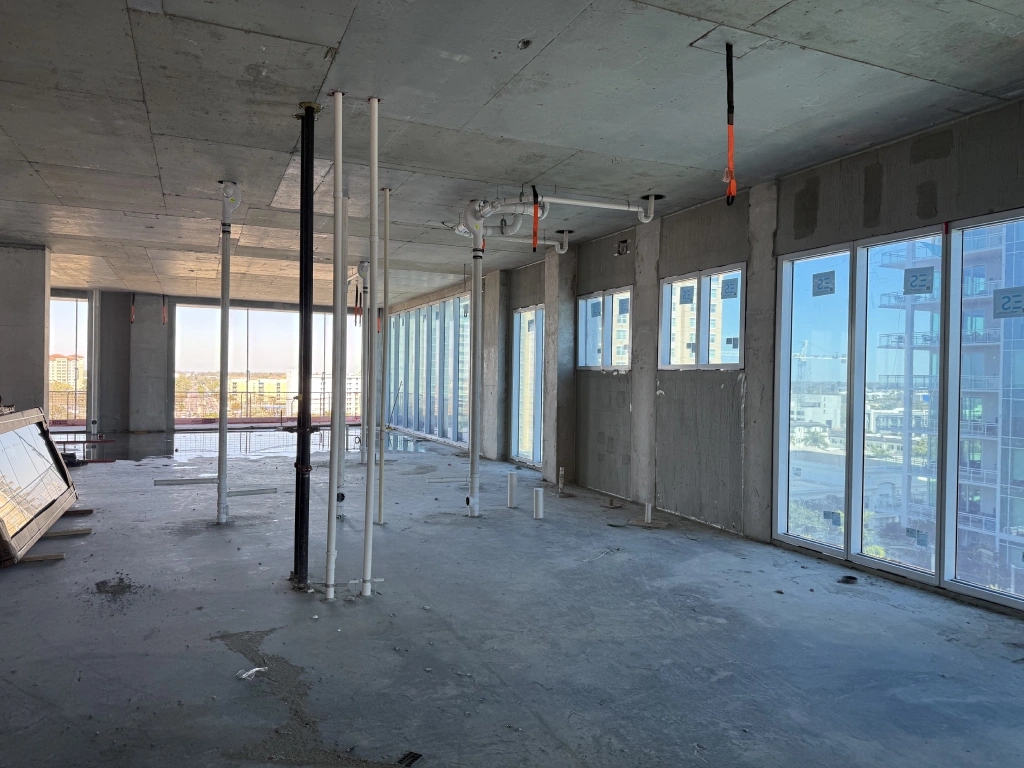

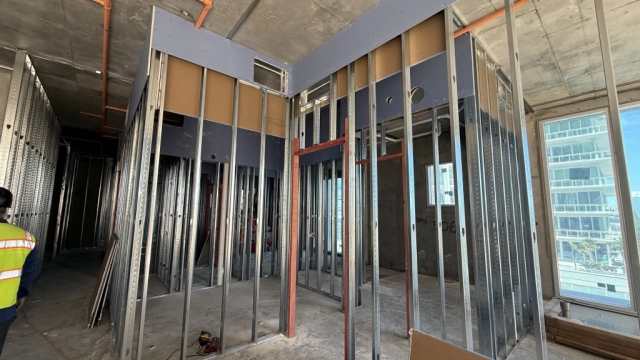

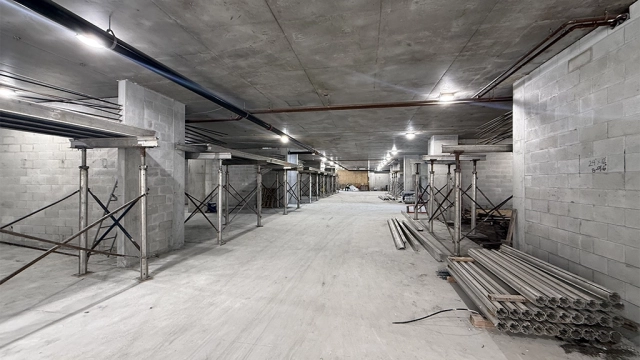

- Layout in progress: Interior layout activities are underway, including unit demising, corridor layouts, and coordination with MEP trades.
- Framing on Level 5 and 6: Interior framing is actively progressing on Level 5 and 6, with crews installing partitions and allowing for rough-in to progress.
- Masonry continues: Masonry work is ongoing across designated elevations

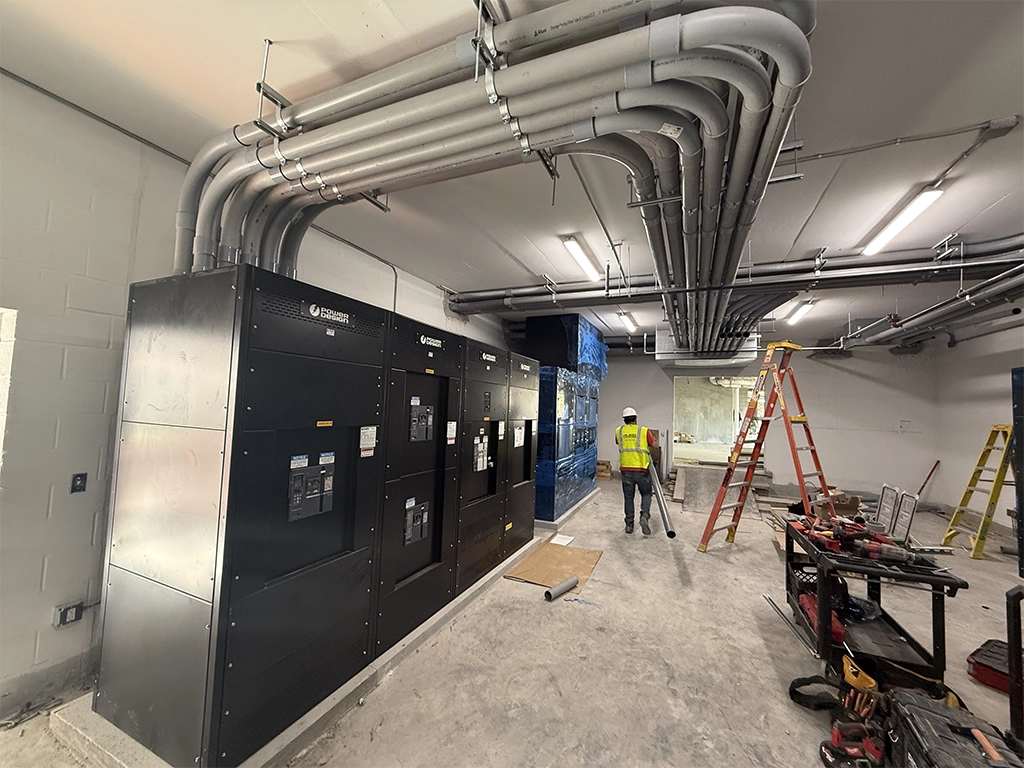

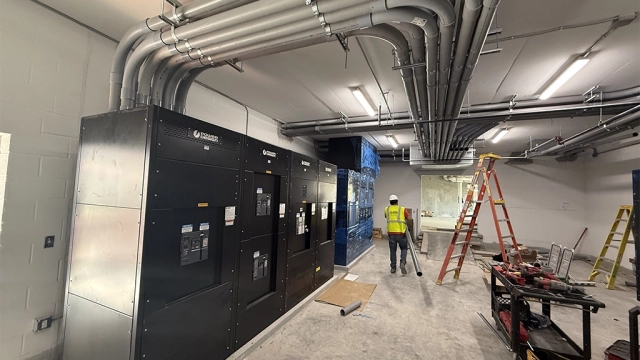

- Mechanical, Electrical, and Plumbing rough-in ongoing: MEP rough-in activities are in progress throughout multiple levels, coordinated with framing and layout work.

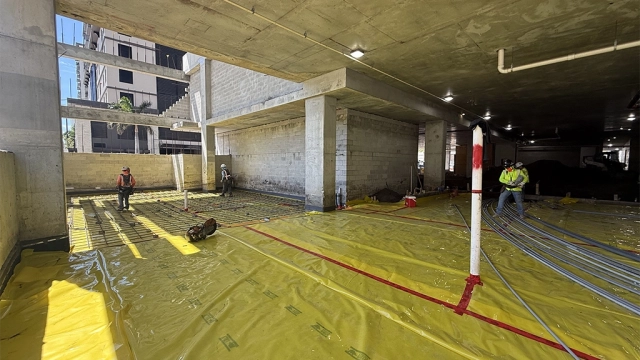

- Slab on grade continues: Townhome slab-on-grade concrete has been successfully poured, Parking garage slabs continue

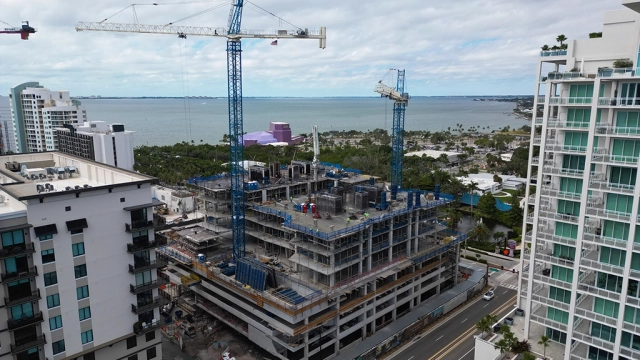

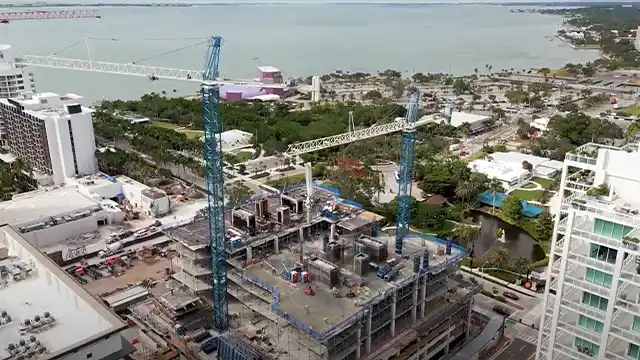

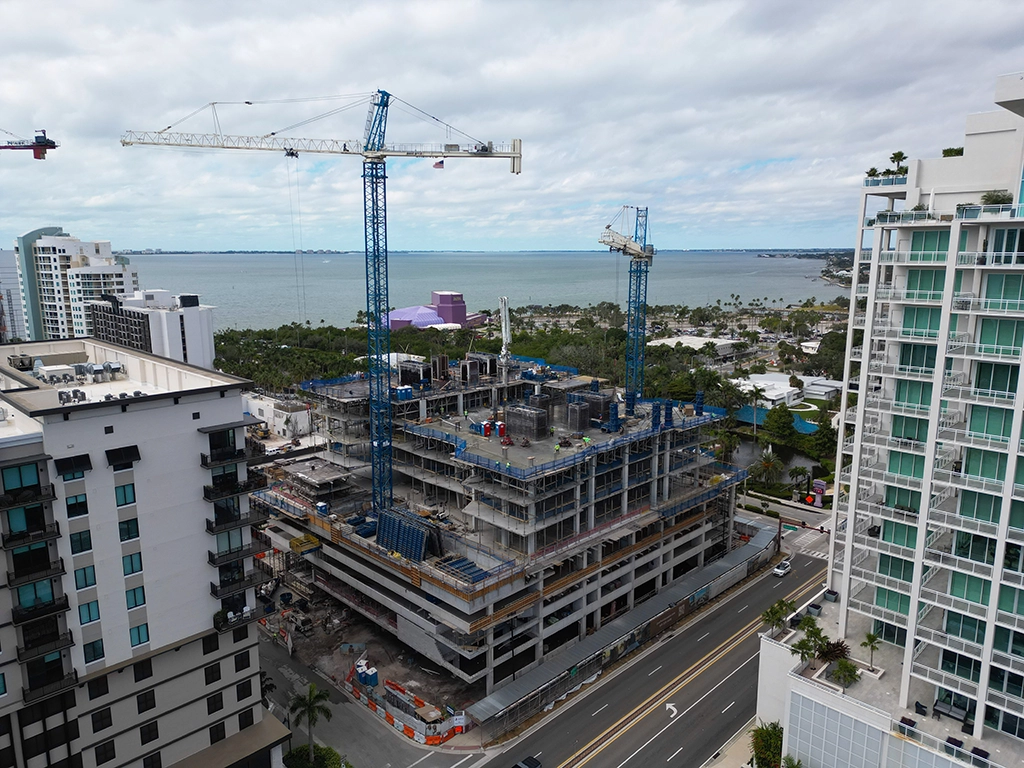

November 2025

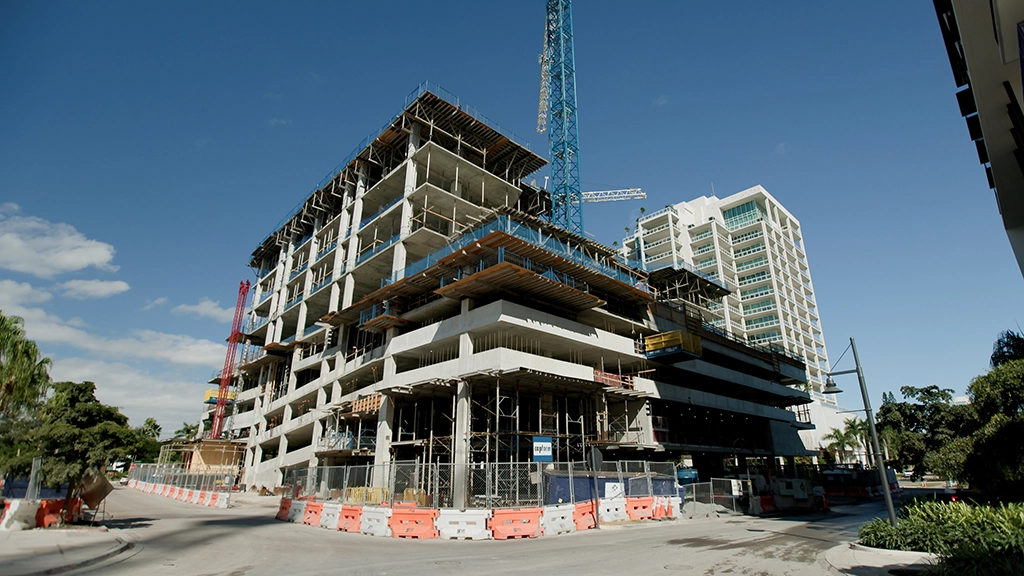

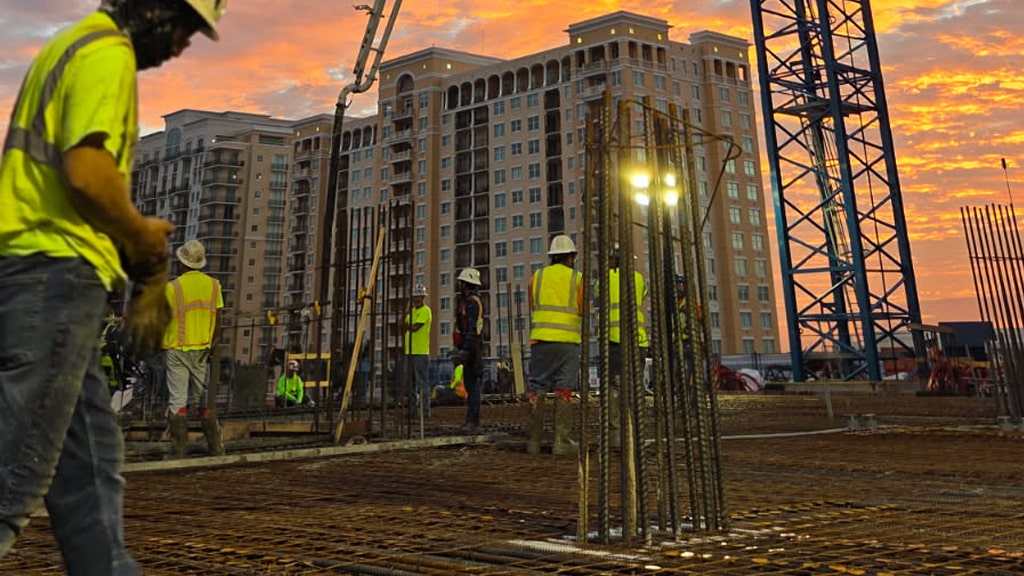

- Concrete poured levels 1-7
- Temporary power completed
- MEP trades fully mobilized on site and are working up the podium
- Unit coordination is complete, and Juneau is releasing materials on time and on schedule
- Underground storm and sanitary in progress
- Hoist installation scheduled for November
- Mobilizing Masonsub in 3 weeks
- Mobilizing framing in 5 weeks
- Masonry mobilized

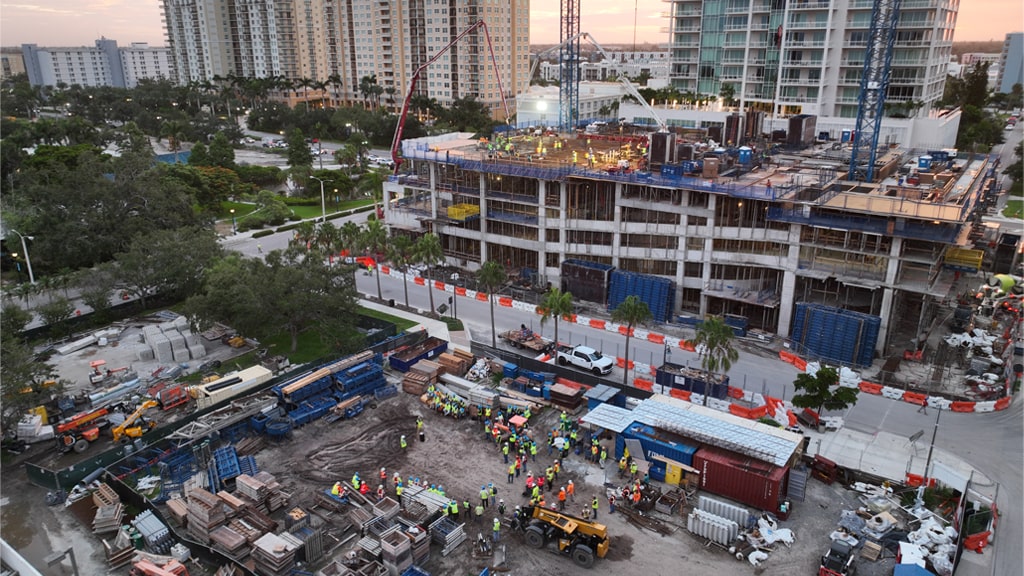

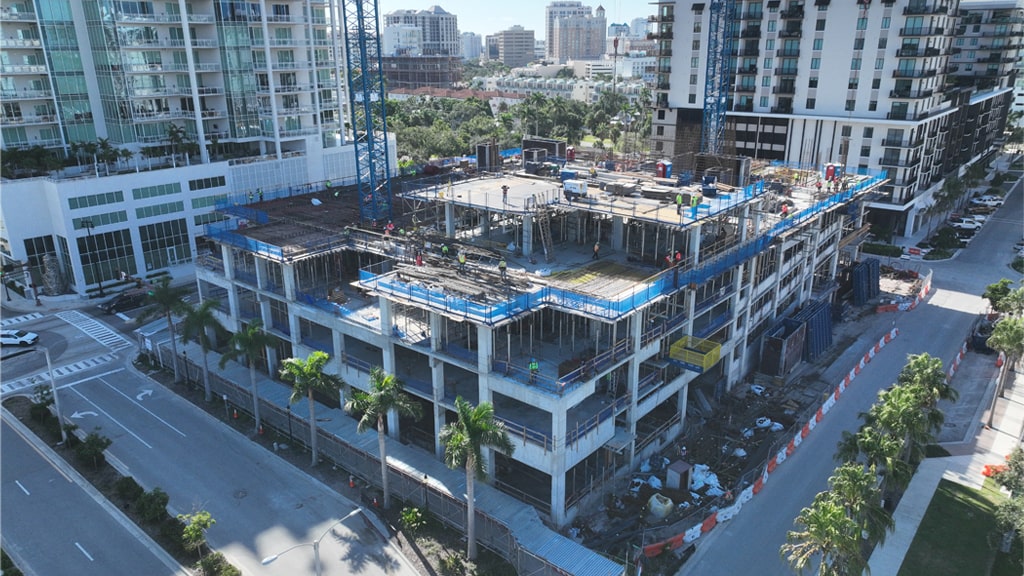

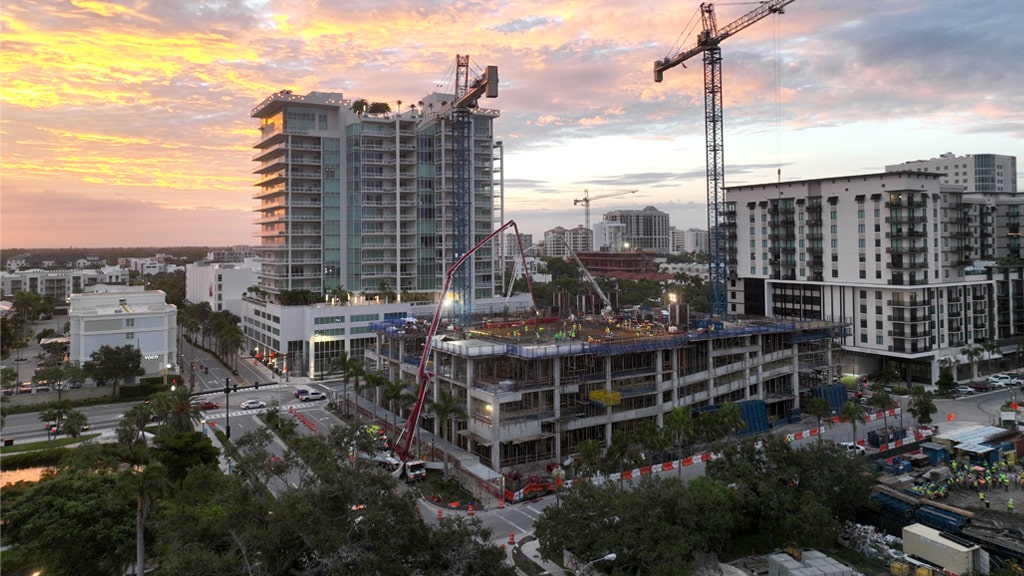

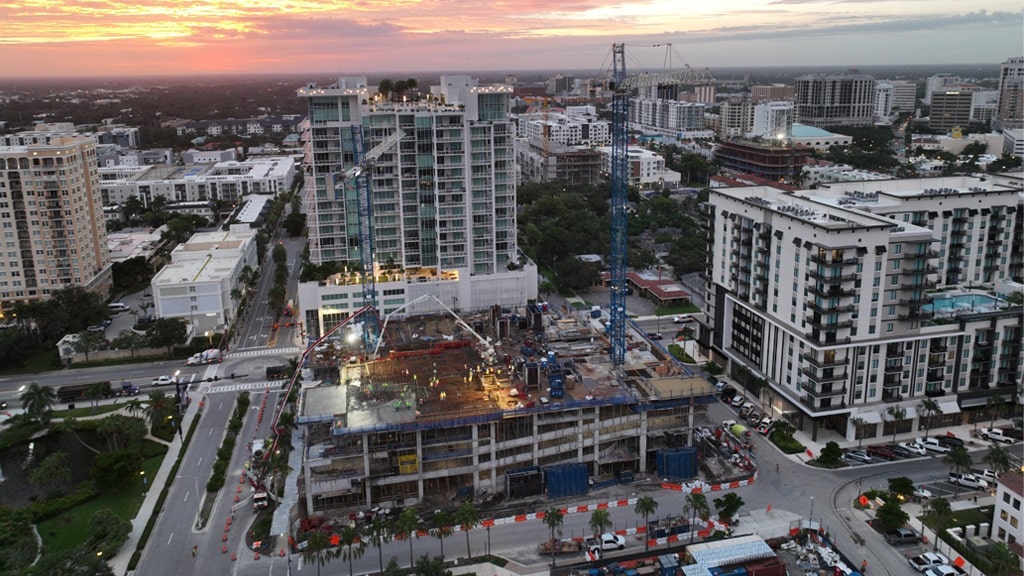

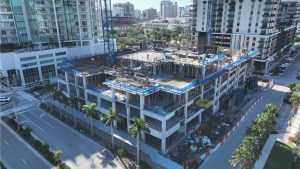

September 2025

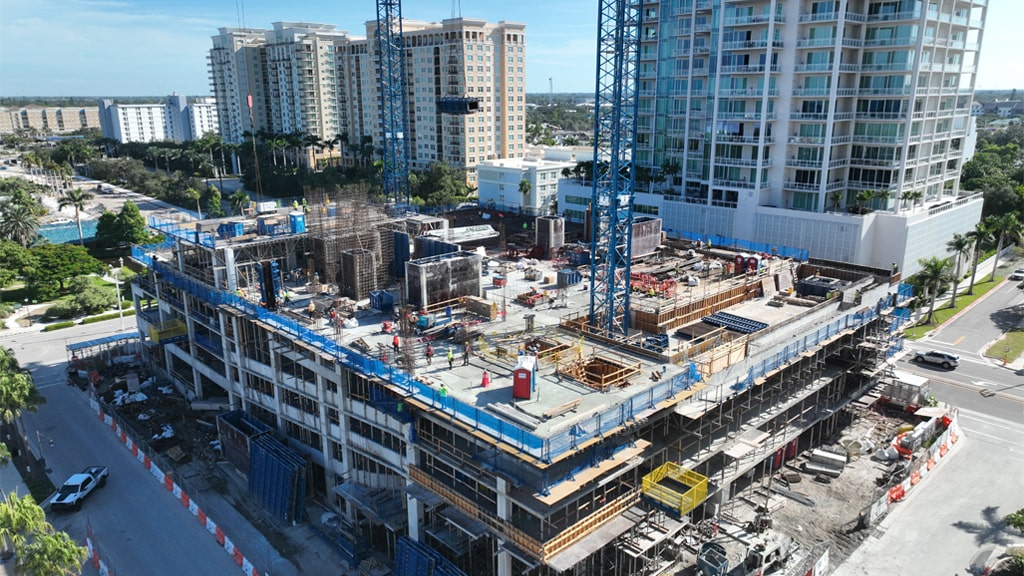

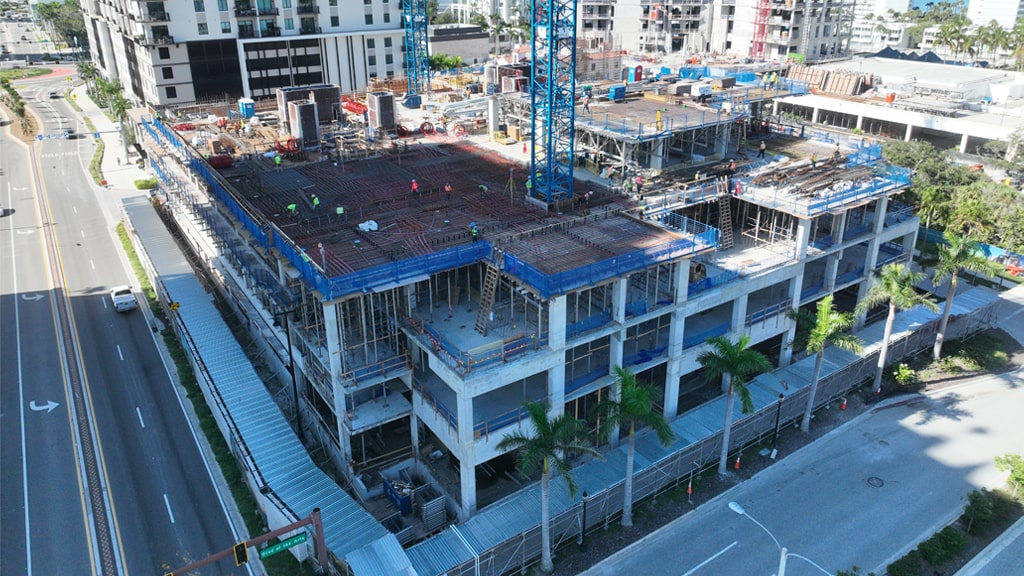

- Concrete poured levels 1-4
- MEP trades fully mobilized on site and are working up the podium
- Temporary power completed
- Unit coordination is complete; Juneau is releasing materials on time and on schedule

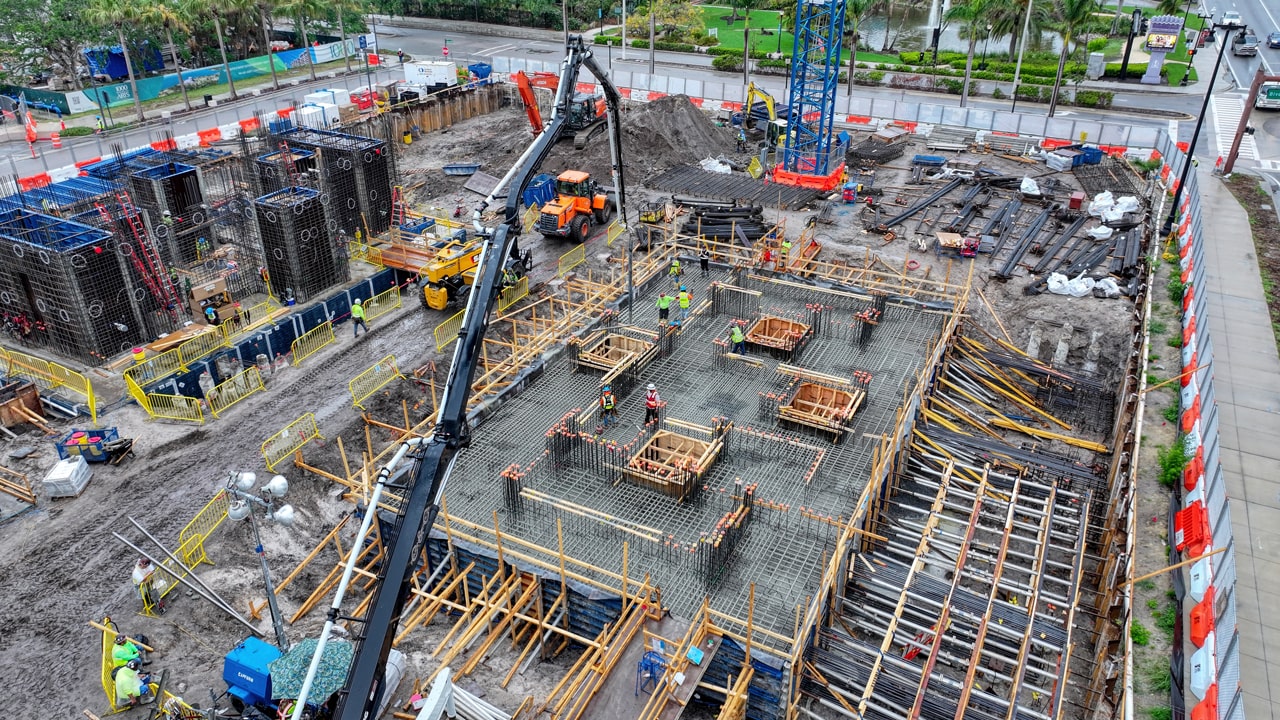

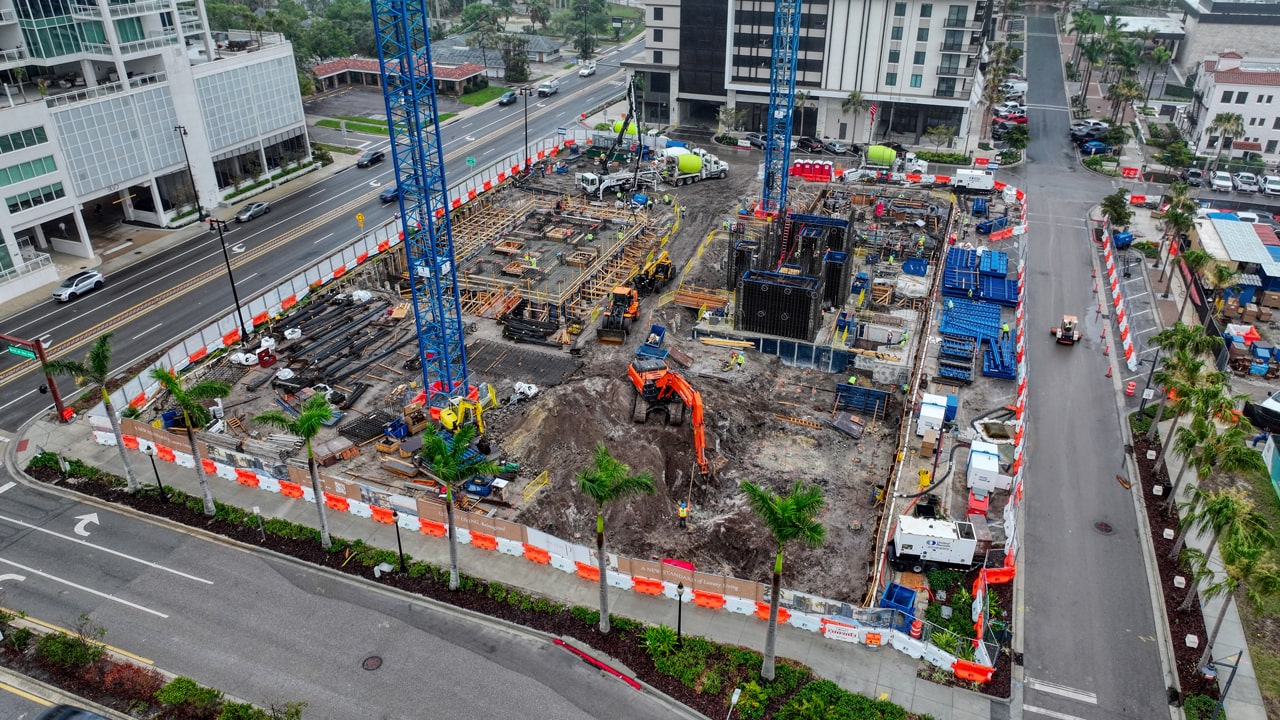

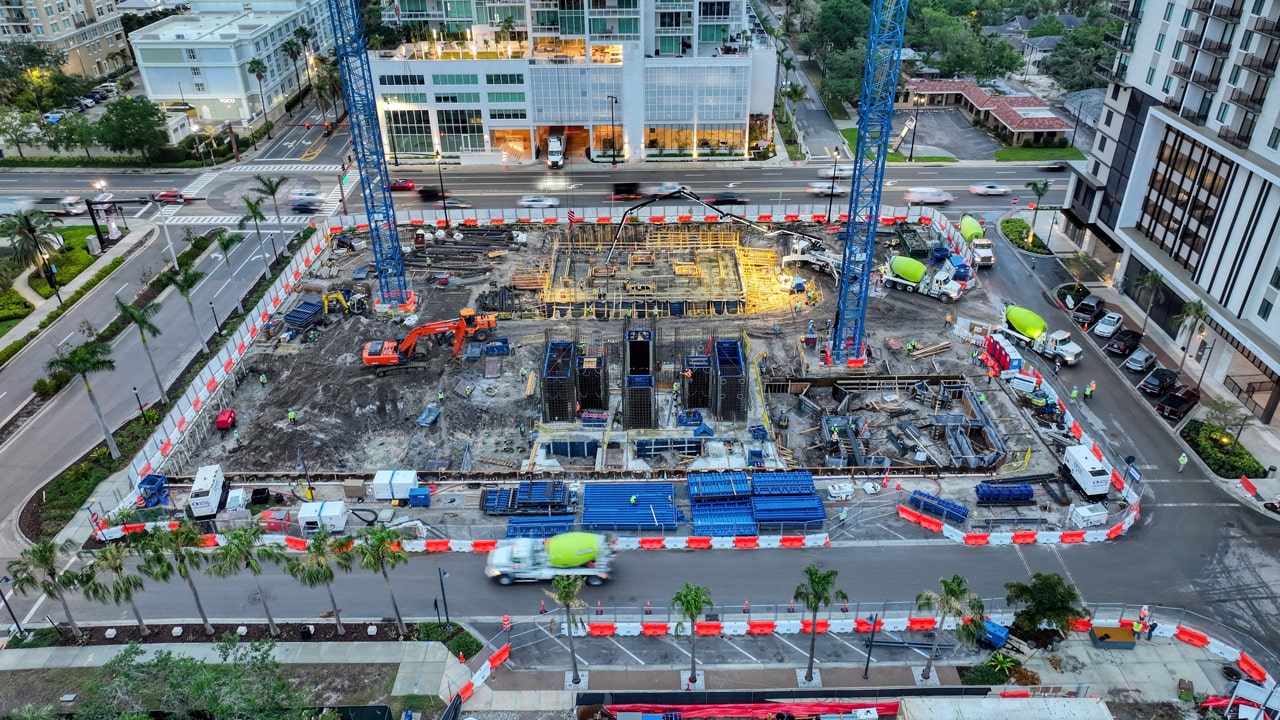

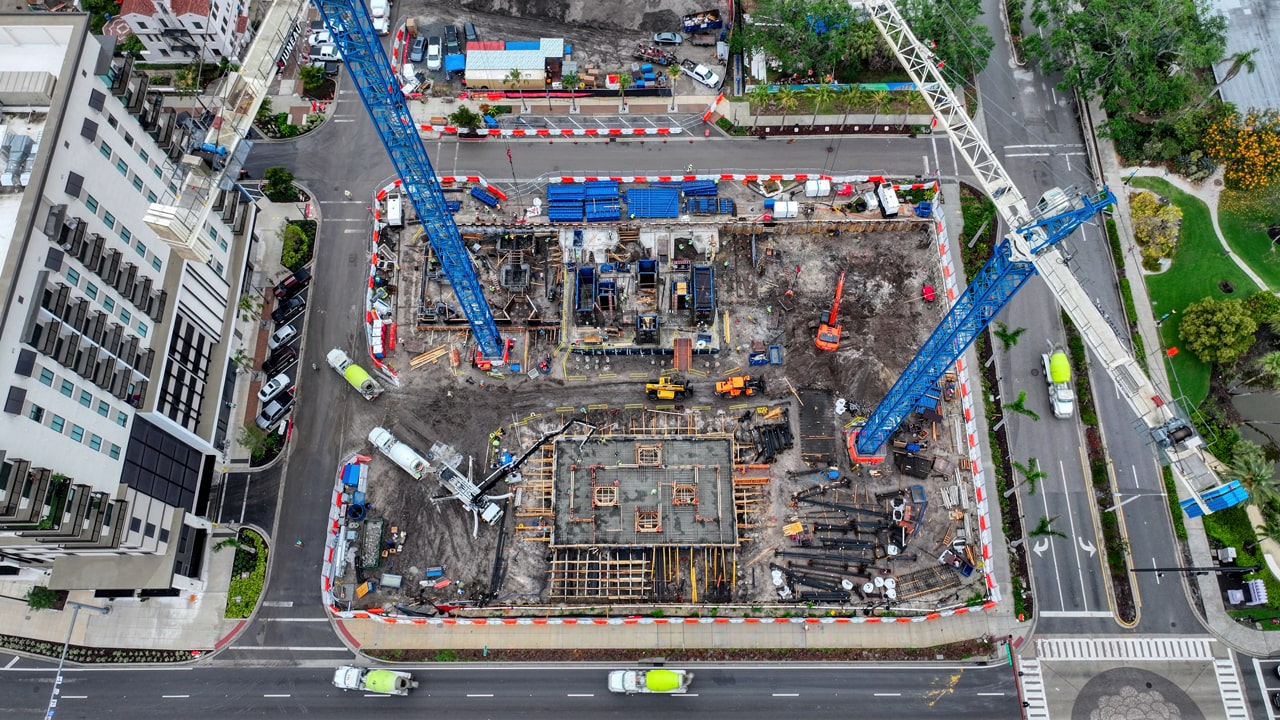

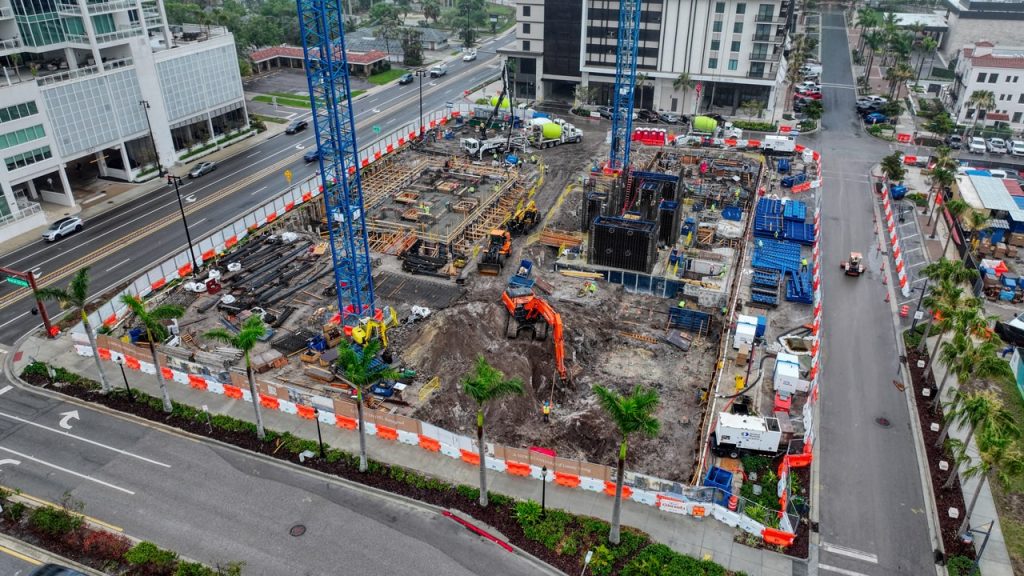

April 2025

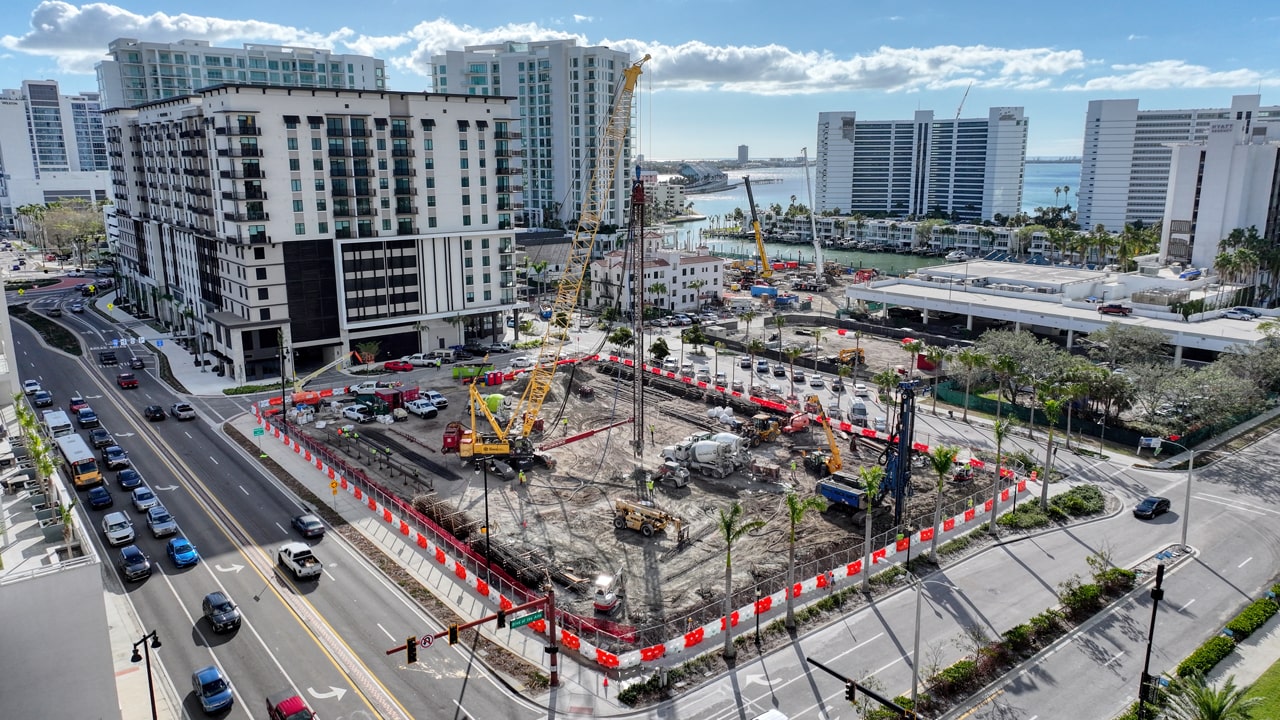

- Completion of deep foundation piles, including demobilization of pile contractor.
- Mobilization of concrete shell contractor.

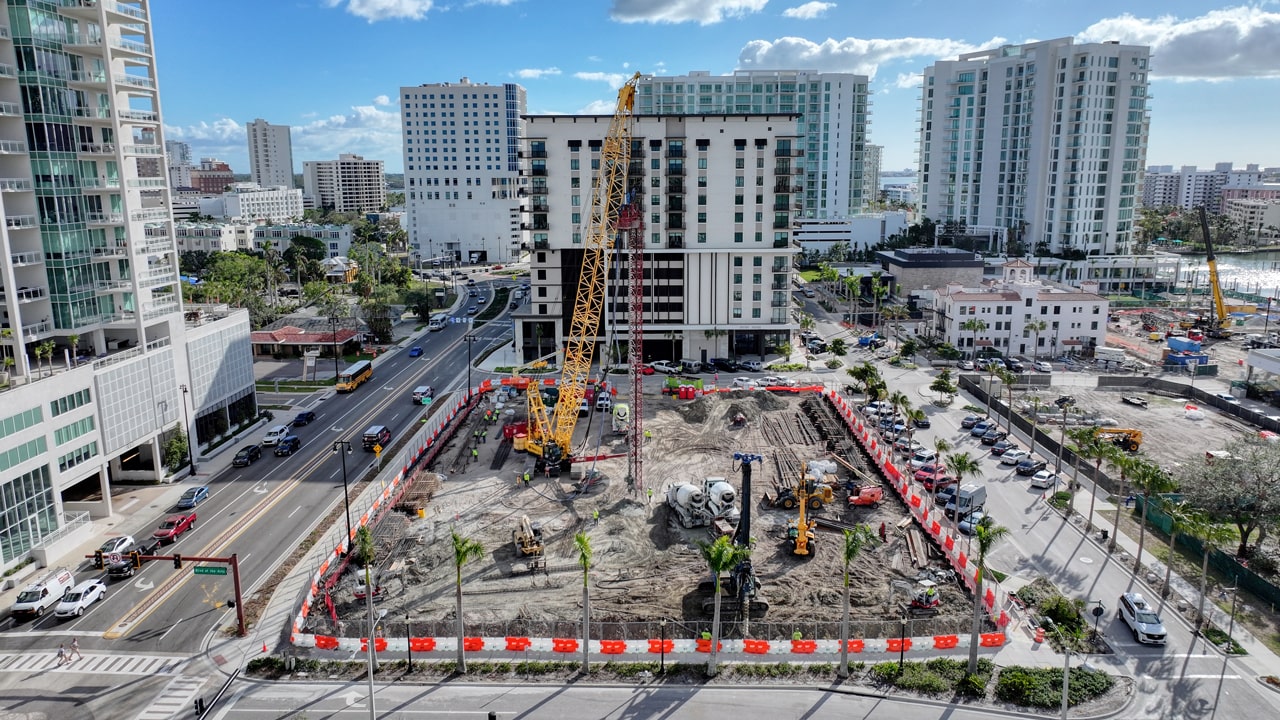

- Erection of north and south tower cranes.

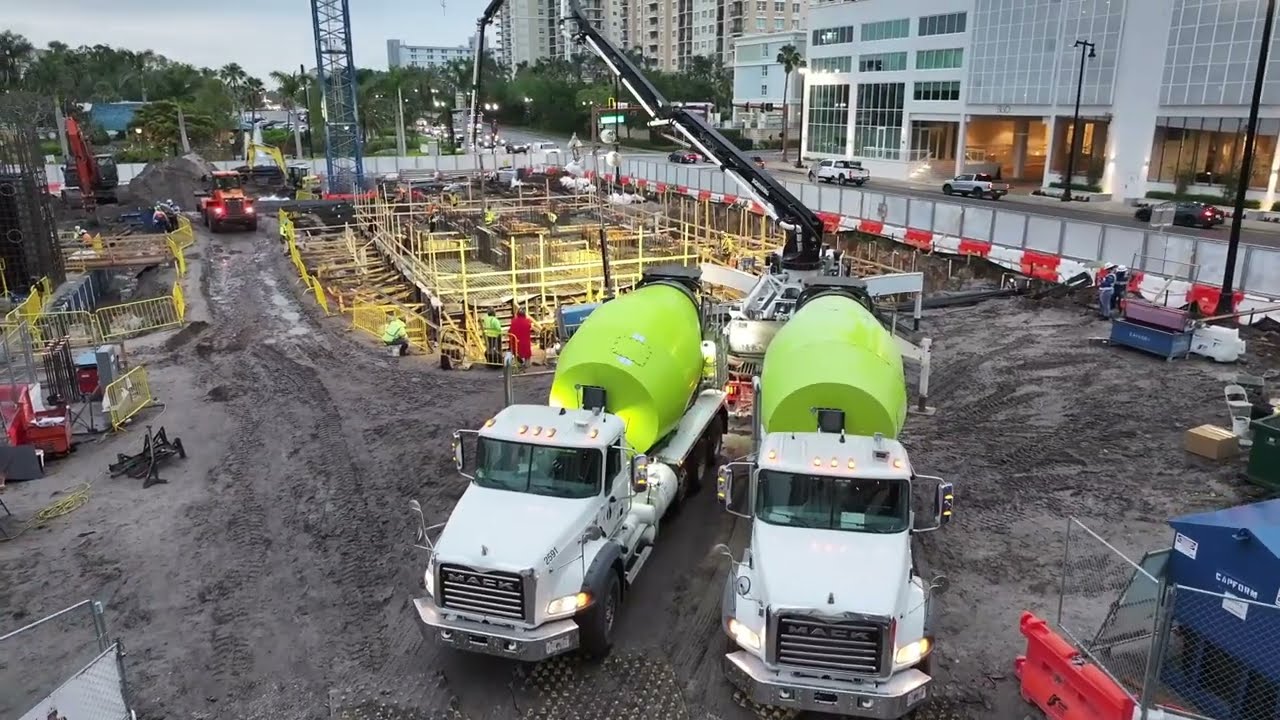

- Foundation excavations, pile chipping, rebar tying, concrete placement, and waterproofing of foundations.
- Site backfilling up to level 1 floor elevation after foundation concrete placement.

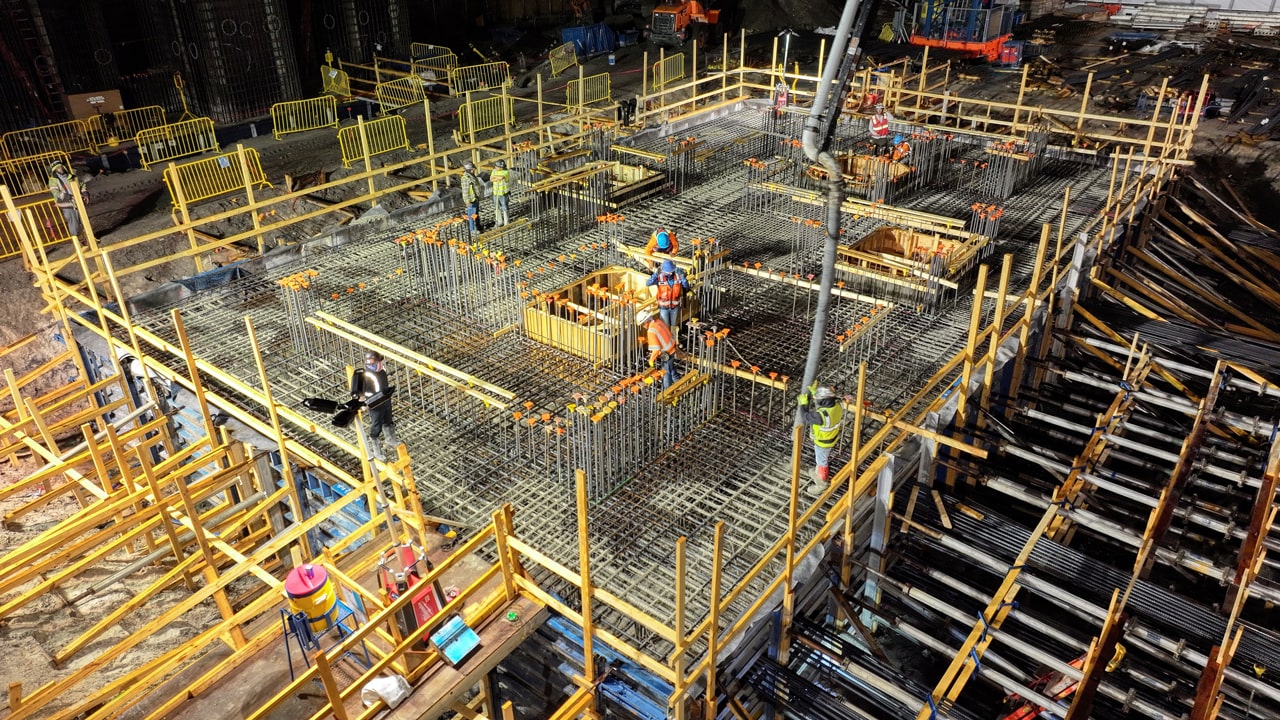

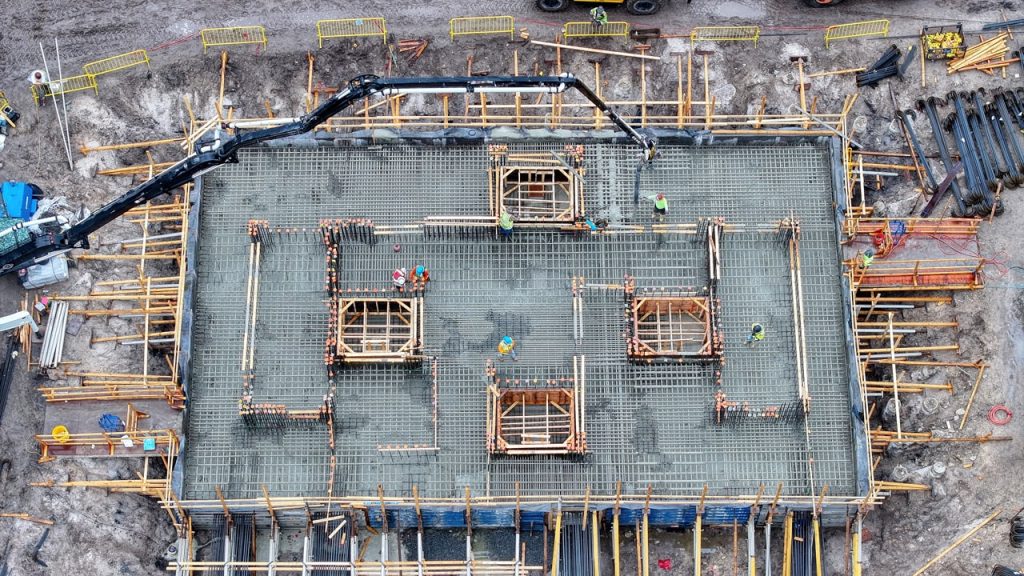

- Level 1 to 1.5 vertical concrete placement, columns and walls.
- Initial underground plumbing and electrical coordination and installation.
- Start of elevated deck formwork construction.

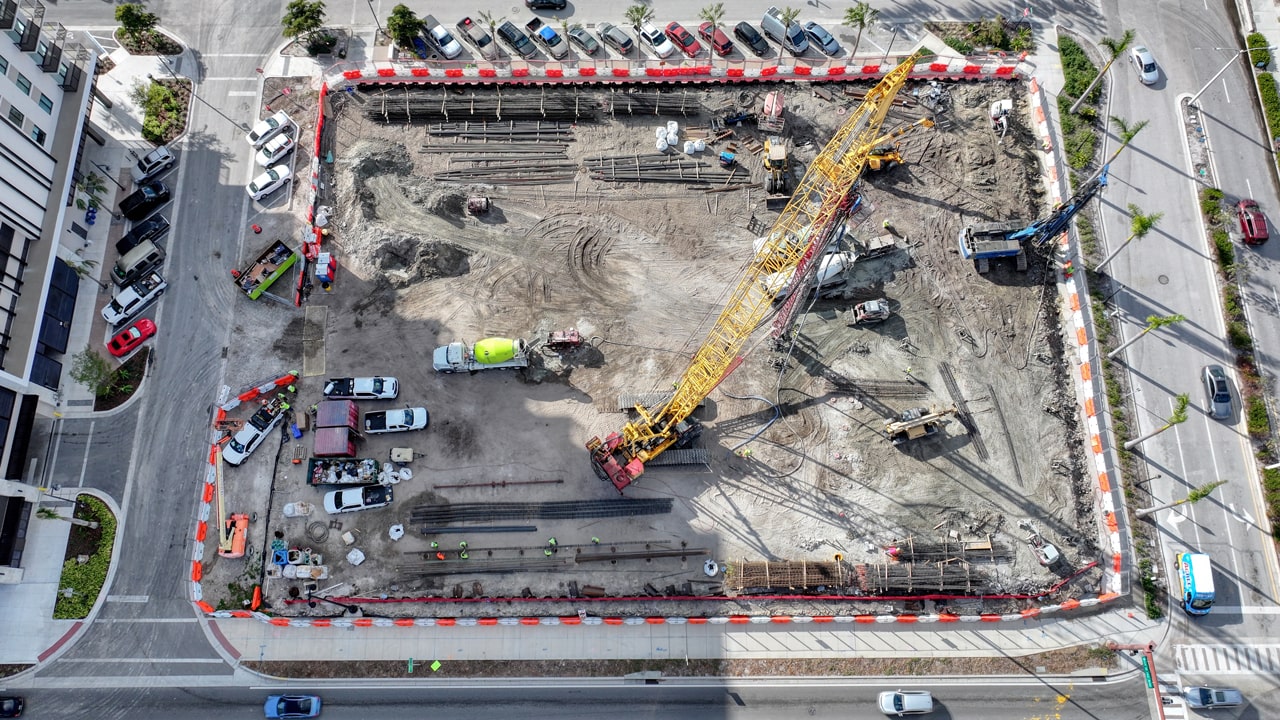

December 2024

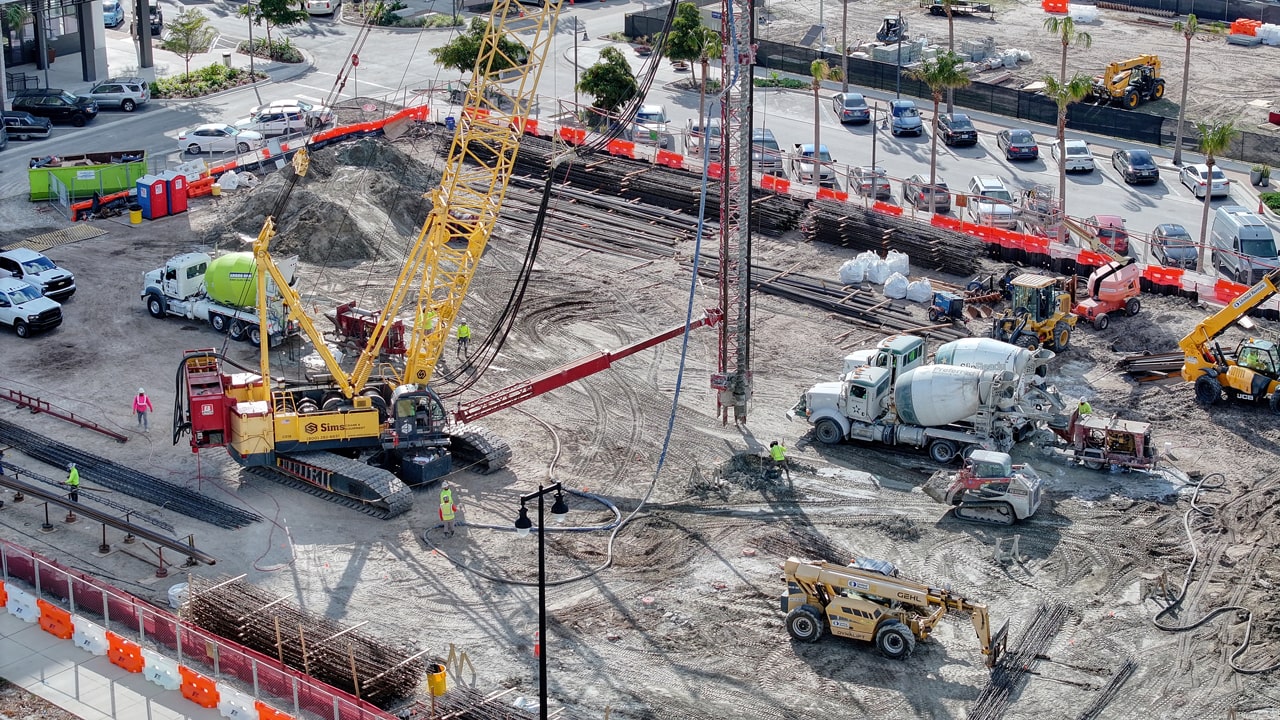

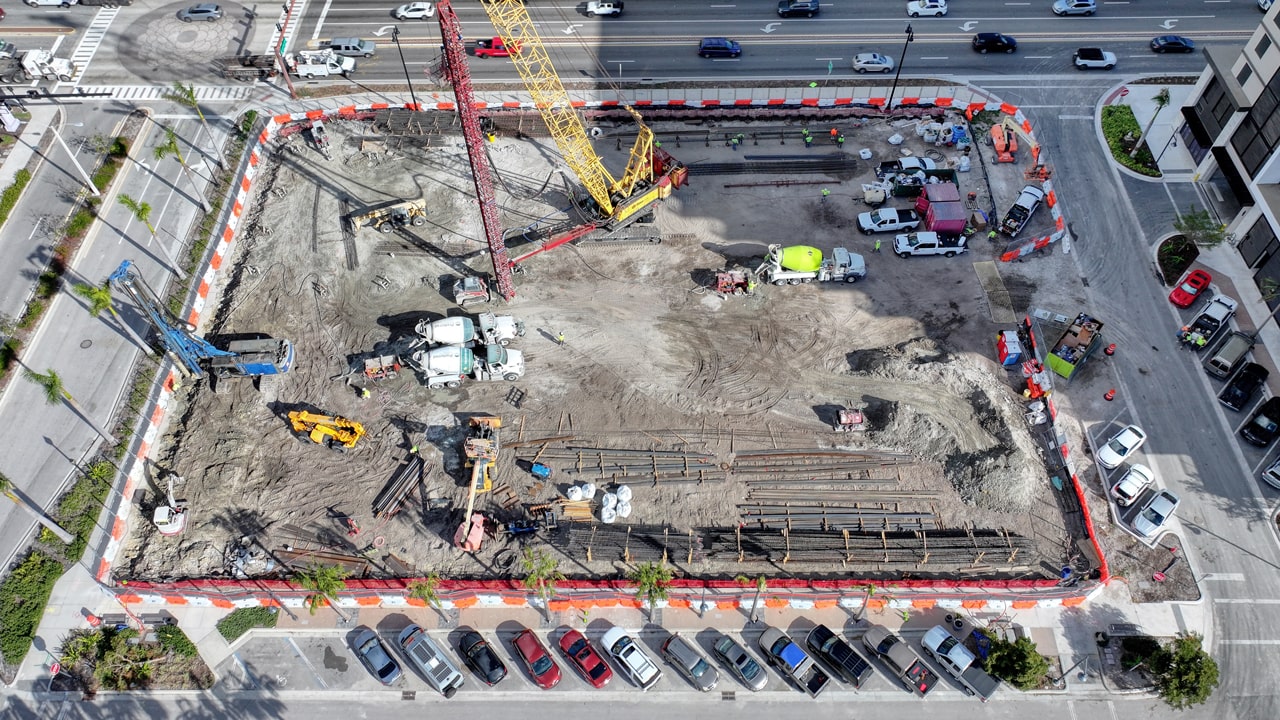

- Deep foundation system installation. 662 85′ deep cast in place concrete piles.
- Installation of underground primary electrical utility service.
